Canada invests $2.1bn in Ontario Power Generation’s modular reactor project

Ontario Power Generation secures CAD3bn ($2.1bn) in public equity financing to construct four modular reactors at Darlington, aiming to ease private sector entry into next-generation nuclear infrastructure.

Share:

Comprehensive energy news coverage, updated nonstop

Annual subscription

8.25$/month*

*billed annually at 99$/year for the first year then 149,00$/year ​

Unlimited access • Archives included • Professional invoice

OTHER ACCESS OPTIONS

Monthly subscription

Unlimited access • Archives included

5.2$/month*
then 14.90$ per month thereafter

FREE ACCOUNT

3 articles offered per month

FREE

*Prices are excluding VAT, which may vary depending on your location or professional status

Since 2021: 35,000 articles • 150+ analyses per week

Ontario Power Generation (OPG) will receive CAD3bn ($2.1bn) in equity financing from two government entities to support its small modular reactor (SMR) project at the Darlington site. The funding aims to mitigate construction and operational risks for the Darlington New Nuclear Project (DNNP), enabling eventual private sector participation.

Two public funds step in

Canada Growth Fund Inc, a CAD15bn investment vehicle established to attract private capital into Canada’s low-carbon economy, has committed up to CAD2bn for a 15% ownership stake. Building Ontario Fund, backed by CAD8bn from the provincial government to support revenue-generating infrastructure, will contribute CAD1bn and hold a 7.5% stake. OPG remains the project’s majority owner and operator.

A structuring project for energy infrastructure

The project plans the deployment of four BWRX-300 reactors developed by GE Vernova Hitachi Nuclear Energy, with a total capacity of 1,200 MW. This output is expected to power approximately 1.2 million homes, with the total cost estimated at CAD20.9bn. The first unit, SMR 1, is slated for completion by the end of 2030, with units 2 through 4 expected in the mid-2030s.

Funding will be released in two phases: the first tranche will cover initial construction of SMR 1, while a second tranche, contingent upon the achievement of specific project milestones, will support the remaining units. This approach seeks to align capital deployment with the evolving project risk profile.

An adaptable investment model

Canada Growth Fund and Building Ontario Fund stated their involvement provides a temporary financial framework to absorb technological and construction risks. The structure is intended to lay the groundwork for future private and Indigenous capital investment.

The project has been selected for expedited review by the federal Major Projects Office, which was created to streamline administrative processes and improve coordination across government levels for large-scale infrastructure projects.

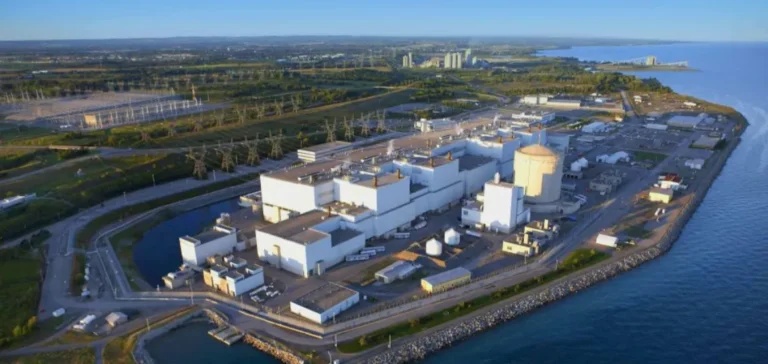

Darlington site progress

OPG began early site preparations in 2022. In July, components for the Harriet Brooks tunnel boring machine arrived, with assembly scheduled for 2026. The 6.97-metre-diameter machine will excavate a 3.4-kilometre tunnel for the condenser cooling system.

Modules for the basemat—the reactor building foundation—are being delivered. The pre-assembly and fabrication buildings for structural and modular components have been completed. Foundations for the radiation waste, control, and service buildings are also finished.

Excavation continues on the reactor shaft, forebay shaft, and condenser cooling water launch shaft. Site grading for the three future SMR units has been finalised.

Framatome’s accident-tolerant fuel prototype has completed a second 24-month cycle in a commercial nuclear reactor in the United States, paving the way for a third phase of industrial testing.
The Wylfa site in Wales will host three Rolls-Royce small modular reactors from 2026, marking a strategic investment in the UK’s nuclear expansion.
EDF confirmed that the Flamanville EPR has reached a major milestone, while planning a nearly year-long shutdown in 2026 for extensive regulatory inspections and key component replacement.
EDF is opening access to its long-term nuclear supply contracts to companies consuming more than 7 GWh per year, an adjustment driven by the gradual end of the Arenh mechanism.
South Korean authorities have approved the continued operation of the Kori 2 reactor for an additional eight years, marking a key milestone in the national nuclear strategy.
A public-private consortium is developing a 5 MW thermal microreactor designed to operate without refuelling for ten years, marking a strategic step in Brazil's nuclear innovation efforts.
EDF has announced that the Flamanville EPR reactor is now operating at 80% of its capacity. The target of reaching full output by the end of autumn remains confirmed by the utility.
The accelerated approval of the Aurora facility’s nuclear safety plan marks a strategic milestone in rebuilding a domestic nuclear fuel production line in the United States.
The Industrikraft consortium will invest SEK400mn ($42.2mn) to become a shareholder in Videberg Kraft, marking a new phase in Sweden’s nuclear project led by Vattenfall on the Värö Peninsula.
MVM Group has signed an agreement with Westinghouse to secure VVER-440 fuel supplies from 2028, reducing its reliance on Russia and strengthening nuclear cooperation between Budapest and Washington.
The delivery of nuclear fuel by Russian subsidiary TVEL to the Da Lat research reactor marks a key step in strengthening the nuclear commercial partnership between Moscow and Hanoi.
US supplier X-energy has formalised a graphite supply contract with Japan's Toyo Tanso for the construction of its first four small modular reactors, in partnership with Dow and backed by the US Department of Energy.
US-based Enveniam has signed an agreement with LIS Technologies Inc. to oversee the design and construction of a new laser-based uranium enrichment facility on American soil.
Faced with shorter approval timelines, several European nuclear firms, including Newcleo, Orano and Urenco, are considering relocating key industrial investments to the United States.
A consortium led by Swedish giants such as ABB, SSAB and Volvo will invest SEK400mn to support the development of small modular nuclear reactors through a strategic partnership with Vattenfall.
Russia and India are preparing an expanded agreement for the construction of VVER-1200 reactors and modular nuclear power plants, while accelerating work at the strategic Kudankulam site.
Fusion Fuel Cycles has begun work on its UNITY-2 facility, a unique test bench designed to validate the full tritium fuel cycle under fusion conditions, marking a key step toward fusion energy.
Framatome will produce TRISO fuel at Romans-sur-Isère as part of a pilot project for advanced nuclear reactors, in partnership with actors such as Blue Capsule Technology.
Sweden’s parliament has approved a major reform authorising uranium extraction, opening the door to a reassessment of the economic potential of mining projects containing this strategic mineral.
South Africa's regulator has authorised Koeberg Unit 2 to operate until 2045 following maintenance work and a long-term safety assessment.
